StoneCrusher Run Calculator

Crusher Run Calculator

Estimate crusher run tons, cubic yards, and delivery loads for compacted base projects.

Base project

Quick presets

Cars, pickups, and delivery traffic

Crusher run to order

7.16 tons

Loose material for a 240 sq ft driveway base at 6 in compacted, with the 15% allowance already in it.

5.11cubic yards loose
240sq ft of base
1truck loads
34sq ft per ton
Compacted base in place
4.44 cubic yards
Weight before the allowance
6.22 tons
Allowance applied
+15%
Spread depth before compaction
6.9 in
Delivery
1 load at 15 tons
Material at $35 per ton
$250

Stone at 1.4 tons/yd³, material only. Excavation, subgrade repair, separator fabric, compactor hire, delivery charges and labour are all separate. Ask the quarry about payload limits and minimum delivery. Estimates only, not professional advice.

Last updated August 5, 2026 by our expert review team.

Fines and binding

Where crusher run belongs in a base, and what will not do its job

Crusher run is crushed stone that still has its fines in it. The fines fill the voids between the larger pieces, which is why it locks up under a compactor and why a washed stone of the same size never will. That single property decides every row below.

Crusher run, ABC, #21AYesLocks together under compaction and carries the wheel load down to the subgrade.
Clean #57 stoneNoDrains freely and never binds, so it keeps moving under traffic instead of holding grade.
Bedding sand, about 1 inn/aSits above a finished base for pavers. It is a screeding layer, never the structure.
Pea gravel or river rockNoRounded and washed, so the pieces roll past each other rather than interlocking.

Because the fines are the point, crusher run has to go down damp and be compacted in shallow passes rather than dumped and driven over. It also has to sit on something firm: it cannot bridge soft organic soil, so topsoil comes off before any stone goes on.

Depth requirement

How deep a crusher run base has to be, and who decides that

Not you. The base has to spread a wheel load wide enough that the subgrade under it never sees more than it can carry, so the depth follows from two things: what will drive over it, and what is underneath. Set both in the calculator's options and your cell is marked below.

FirmAverageSoft, wet
Foot & lightwalkway, patio
3 in4 in5 in
Cars & pickupsdriveway, parking
4 in6 in8 in
Heavy / RVtrailers, equipment
6 in8 in10 in

Every depth here is one of the nine figures this calculator's own traffic and subgrade option lists carry. It publishes no CBR value and no agency base table, because this repo holds neither.

Average subgradewheel loadspread over this width6 in you set6 in required
Both depths are drawn to one scale on this canvas, so the two rectangles are directly comparable. The spreading lines are schematic at a fixed slope: no load-distribution angle is published anywhere in this calculator, so none is labelled as one.
The dropdown, decodedFour cells above
Walkway base3 inFoot traffic, firm ground
Shed or slab base4 inFoot traffic, average ground
Driveway base6 inCars, average ground
Heavy-use pad8 inCars, soft or wet ground

Your base against it

6 in

required for cars & pickups on average ground. The depth you have set meets it exactly.

Traffic
Cars & pickups
Subgrade
Average
Depth required
6 in
Depth in the calculator
6 in

Separator fabric: optional. Firm, well-drained soil usually does not need a separator under the stone.

Why depth follows the ground

A wheel presses on a small patch of surface. By the time that pressure reaches the subgrade it has fanned out through the stone, and the deeper the base the wider the patch it lands on. Firm ground can take a narrow patch. Soft clay cannot, so it needs more stone above it to spread the same load further before it arrives.

Yard tickets

Four crusher run orders, from a walkway pad to a parking pad

The four quick presets, each at its own depth and allowance, priced at $35 per ton and at 1.4 tons/yd³. Every figure comes out of the same arithmetic the calculator runs, so you can type any of them in and get the identical answer.

Driveway section

7.16

tons

$250

Pad
20 × 12 ft
Area
240 sq ft
Spec
6 in compacted, 15% allowance
Loose
5.11 cubic yards

A small delivery is often priced as a minimum load, so call the quarry before ordering just 7.16 tons.

Paver base

8.94

tons

$313

Pad
20 × 15 ft
Area
300 sq ft
Spec
6 in compacted, 15% allowance
Loose
6.39 cubic yards

Aggregate base only. Bedding sand and the pavers themselves are separate layers on top.

Shed pad

2.32

tons

$81

Pad
12 × 10 ft
Area
120 sq ft
Spec
4 in compacted, 12% allowance
Loose
1.66 cubic yards

Extend the base past the shed footprint so roof runoff does not erode the edge.

Parking pad

16.59

tons

$581

Pad
20 × 20 ft
Area
400 sq ft
Spec
8 in compacted, 20% allowance
Loose
11.85 cubic yards

The 20% allowance here is the heavy-pad setting, because a thicker base over soft ground loses more to compaction.

Moisture and edges

Getting crusher run to lock up instead of staying loose

Not a sequence, so not numbered. Each one is the difference between a base that holds grade and a pile of stone that happens to be the right size.

Order for the loose material you need delivered, not only the compacted volume. Crusher run with fines tightens up under a plate compactor.

Build driveway and paver bases in lifts. Spread 3 in to 4 in loose, mist it damp, compact it, then place the next lift.

Strip topsoil before placing base material. Crusher run cannot bridge soft organic soil, and the finished surface will settle.

For pavers, crusher run is the structural base. Keep the bedding sand separate and hold it to about 1 in after screeding.

For full driveway builds with surface stone, compare this base estimate with the gravel driveway calculator.

If your supplier quotes recycled concrete instead, use the crushed concrete calculator to compare weight and cost.

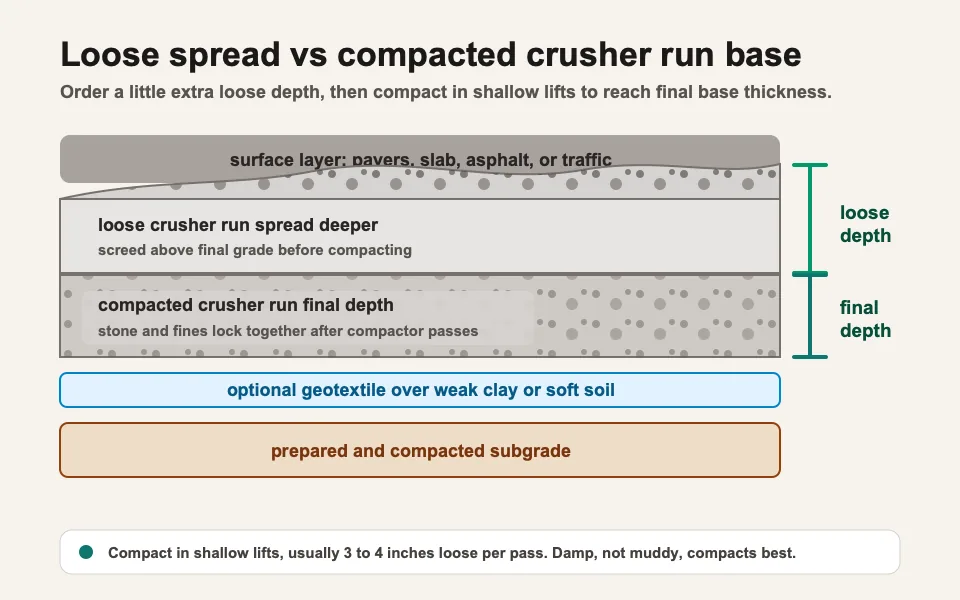

Cross-section diagram showing loose crusher run spread deeper than the final compacted base, with optional geotextile over prepared subgrade.
Why the allowance exists: the loose pile has to start higher than the line you are aiming at, because the fines have not filled the voids yet.

Tons per yard

Crusher run tonnage, one step at a time

Area times compacted depth gives the finished volume. The allowance turns that into the loose volume a truck has to bring, and the density turns loose volume into the weight the quarry actually bills you for.

compacted yd³ = length × width × (depth ÷ 12) ÷ 27loose yd³ = compacted yd³ × (1 + allowance)order tons = loose yd³ × densityloads = ceil(order tons ÷ truck payload)cost = order tons × price per ton

The allowance is applied to the volume, before the density, so it carries through to both tons and cost. In reverse mode the same chain runs backwards: the weight you already have becomes a loose volume, the allowance comes back out of it, and the compacted volume is divided by your depth to give an area.

FigureValue
Default density1.4 tons/yd³
Limestone #411 or #21A1.45 tons/yd³
Recycled concrete base1.35 tons/yd³
Allowance for a standard base15%
Allowance range on offer10 to 25%
Truck payload the loads count on15 tons
Shallowest depth preset, walkway3 in
Deepest depth preset, heavy pad8 in

Every row is a constant the calculator itself uses. Nothing on this page assumes a figure that is not one of them.

Pumping and rutting

What a crusher run base fails from, and it is rarely the stone

A rutted base almost never means the wrong material arrived. It means the order, the ground under it, or the compaction was wrong, and none of those is fixable from the surface afterwards.

01

Ordering finished volume only

Add 10 to 20% so loose material reaches the planned depth after compaction.

02

Skipping compaction

Driving over the pile is not enough. Use a plate compactor or roller in thin lifts.

03

Confusing clean stone with crusher run

Clean #57 drains well but does not bind like dense-grade crusher run with fines.

04

Ignoring the delivery load

Small orders may trigger minimum fees, and large loads may exceed driveway or street limits.

05

Placing it on topsoil

Remove soft organic material and compact the subgrade before the base goes down.

06

Using it as bedding sand

For pavers, keep crusher run below the bedding layer. Screed sand or fine chip on top.

Common mix-ups

Crusher run, answered: gravel, tons, pavers, allowance

Six answers in the order the questions tend to arrive, starting with the one that sends people home with the wrong stone.

Is crusher run the same as decorative gravel?

No. Crusher run is a compactable base mix with crushed stone and fines. Decorative gravel is usually washed or rounded, so it does not lock together the same way.

How deep should crusher run be for a driveway?

Use 4 inches compacted for light car traffic on firm soil, 6 inches for normal residential driveways, and 8 inches or more for trailers, RVs, or weak subgrade.

How many tons are in a cubic yard of crusher run?

A practical planning value is 1.35 to 1.45 tons per cubic yard. This calculator defaults to 1.4 tons per cubic yard and lets you change it in advanced options.

Should I order tons or cubic yards?

Most quarries sell crusher run by the ton. Cubic yards help you visualize volume, but the final order is usually tons plus a compaction allowance.

Can crusher run go under pavers?

Yes for a traditional dense-grade paver base. Compact it in lifts, then add a separate 1 inch bedding layer of sand or fine chip before laying pavers.

Why add a compaction allowance?

The loose load settles as fines fill voids between larger stone. If you order only the finished compacted volume, you can come up short before reaching grade.

Coverage per ton

How far a ton of crusher run goes at each base depth

Every cell is the area one ton covers, at the four depth presets and the three stock densities, using the 15% allowance currently set in the calculator. Change the allowance and the whole table moves with it.

DepthStandardLimestoneRecycled
3 in67.164.869.6
4 in50.348.652.2
6 in33.532.434.8
8 in25.224.326.1

Figures are sq ft per ton. A denser stone covers less ground per unit of weight, which is why the recycled column reaches furthest and the limestone column least.

Disclaimer

These estimates are for planning purposes only. Actual costs vary by location, material availability, and project complexity. Always get at least 3 local quotes. This calculator does not replace professional advice.
